Take a look at the progress!

2023 Bond

On November 7, 2023, the West Ottawa community approved a $237 million bond proposal to invest in the future of our schools. This historic support allows the District to move forward with significant infrastructure improvements, new classrooms and gymnasiums at two elementary schools, and the construction of an Aquatics and Community Center to replace the beloved Harbor Lights Pool, which has served our community for more than 60 years.

This bond also supports many of our District initiatives, including the creation of outdoor classrooms at all nine elementary schools, flexible furniture that promotes collaborative learning, and the installation of BenQ interactive boards in every classroom throughout the District.

Completed Bond Projects:

DISTRICT WIDE

  • BenQ Boards (2024)

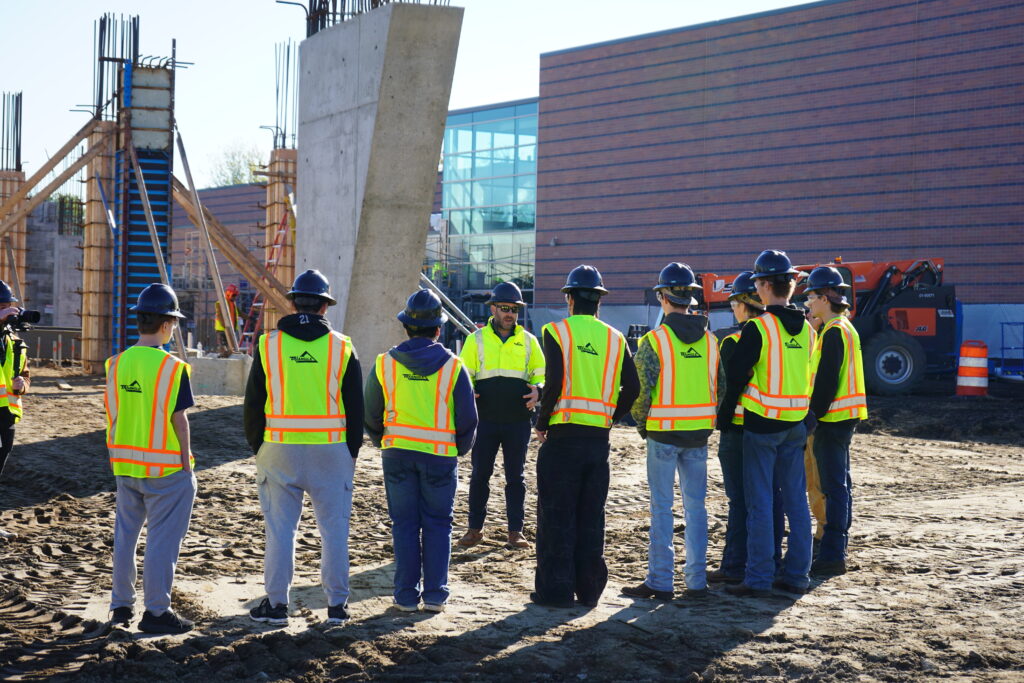

  • Community & Aquatic Center (Site began in 2024, completion 2027)
  • Districtwide Radio Infrastructure (Safety & Security, 2025)
  • $300k Band Instrument Purchases (2024, 2025, 2026)
  • Elementary Outdoor Classrooms (2025)
  • Four (4) New School Buses (Summer 2025)
  • Three (3) New 10-Passenger Vans (Summer 2025)
  • Student Chromebook Replacements (Summer 2025)
  • High School Track & Field Events Relocation (Summer 2025)
  • Middle and High School Athletic Concession Stands and Bathrooms (Summer 2026)

HIGH SCHOOL

  • WOBN Upgrades (April 2024)
  • HSN Gym Video Boards & Center Scoreboard (Summer 2025)
  • Library Furniture & Alternative Seating (Summer 2025)

MACATAWA BAY and/or HARBOR LIGHTS MIDDLE SCHOOLS

  • Macatawa Bay Planetarium (April 2024)
  • Macatawa Bay Cafeteria Furniture (April 2024)
  • Harbor Lights Classroom Furniture (April 2024)
  • Macatawa Bay Roof (Summer 2025)
  • Library Furniture & Alternative Seating (Summer 2025)

ELEMENTARY SCHOOLS

  • Elementary Furniture (Summer 2025)
    • Lakeshore (Summer 2025)
    • Los Lagos Bilingual Academy (Summer 2025)
    • Riley Farms (Summer 2025)
    • Sheldon Woods (Summer 2025)
    • Waukazoo (Summer 2026)
    • Woodside (Summer 2026)
  • Sheldon Woods Gym Addition & Building Renovations (May 2024 – Summer 2025)
    • Selective flooring, casework, ceiling tiles, HVAC, lighting, classroom & office renovations finished in 2024.
    • The old gymnasium was converted to a cafeteria / large group space (Summer 2025)
  • Lakeshore Elementary Improvements (Summer 2025)
    • New Lockers
    • New Door Hardware
    • Remodel of group / teacher bathrooms
    • Interior lighting replacement
    • EPDM Replacement over Mezzanine Roof
    • Flooring Replacement
    • Unit Ventilators – Air Conditioning
    • Fire Protection Upgrade
    • Electrical Panels
    • Replace domestic water piping
  • Lakewood Elementary
    • Metal & Membrane Roof Replacement (2025)
  • Woodside Elementary Improvements (Summer 2026)
    • New Lockers
    • New Door Hardware
    • Remodel of group / teacher bathrooms
    • Interior lighting replacement
    • EPDM Replacement over Mezzanine Roof
    • Flooring Replacement
    • Unit Ventilators – Air Conditioning
    • Fire Protection Upgrade
    • Electrical Panels
    • Replace domestic water piping
  • Waukazoo Elementary Improvements (Summer 2026)
    • New Lockers
    • New Door Hardware
    • Remodel of group / teacher bathrooms
    • Interior lighting replacement
    • EPDM Replacement over Mezzanine Roof
    • Flooring Replacement
    • Unit Ventilators – Air Conditioning
    • Fire Protection Upgrade
    • Electrical Panels
    • Replace domestic water piping
  • Los Lagos Bilingual Academy (Summer 2026)
    • Gym & Classroom Addition
    • Roof Replacement

Let's Get social Follow Along
